Blue Line Now
Blue Line Now serves as a snapshot of the construction work for the Blue Line. Below, you will find a high-level overview of the project, important construction and utility work, and motorist and rider impacts. For more specific details, please review the Blue Line webpages listed above.
Blue Line Summary
The Blue Line will run 24 miles, connecting the Indianapolis International Airport to the Town of Cumberland via downtown Indianapolis along I-70, Holt Road and Washington Street. The line is scheduled to open for service in 2028. Once complete, it will offer faster, safer and more reliable service.
Beyond transit, the project also brings new street paving, improved sidewalks and pedestrian crossings, and ADA-compliant curb ramps to the Washington Street corridor, making it safer and more accessible for all.
IndyGo is committed to supporting residents, businesses and neighborhoods along the corridor. To access resources and stay updated on project construction, sign up for the Blue Line newsletter here.
Blue Line Construction
IndyGo’s work on the Blue Line, its third Bus Rapid Transit (BRT) line, has partially closed three parts of Washington Street. See major motorist detours and rider maps below for more details. To learn more about utility work along the Blue Line, click here.
Utility Outages and Relocations
Experiencing a water or natural gas outage? Many underground utility lines must be relocated before Blue Line construction crews can fully begin their work. Citizens coordinates the required relocation of water, sewer and natural gas lines. This work may require a temporary service disconnection (generally lasting fewer than eight hours), but crews will work to reconnect service as soon as possible. Citizens hosts an online map of reported utility outages as well as a map of ongoing construction which includes utility work for the Blue Line. While not all outages or construction areas may be entirely represented on these maps, they are good tools to determine whether the outage or construction you are encountering is related to Blue Line.
Holt Road to Belmont Avenue
Motorist Detour
Washington Street is open to one lane of traffic in each direction.
Indianola Park underground detention facility construction is in progress. Some activities are restricted at the park due to construction.
On Washington Street, construction is in progress for the future Harding Street and Belmont Avenue stations.

Pedestrians will have crosswalk availability throughout construction, but full accessibility won’t be available until tentatively March 2026.
Work on the Harding Street Station is underway.
Rider Detour
Work in this section is scheduled for late 2025 through mid-2028.

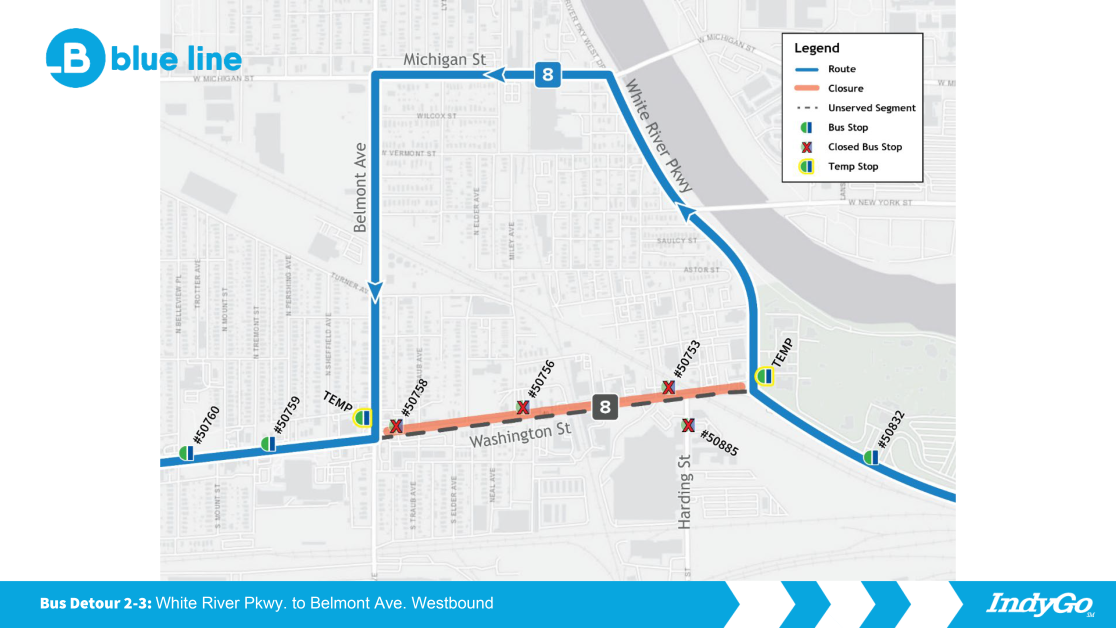

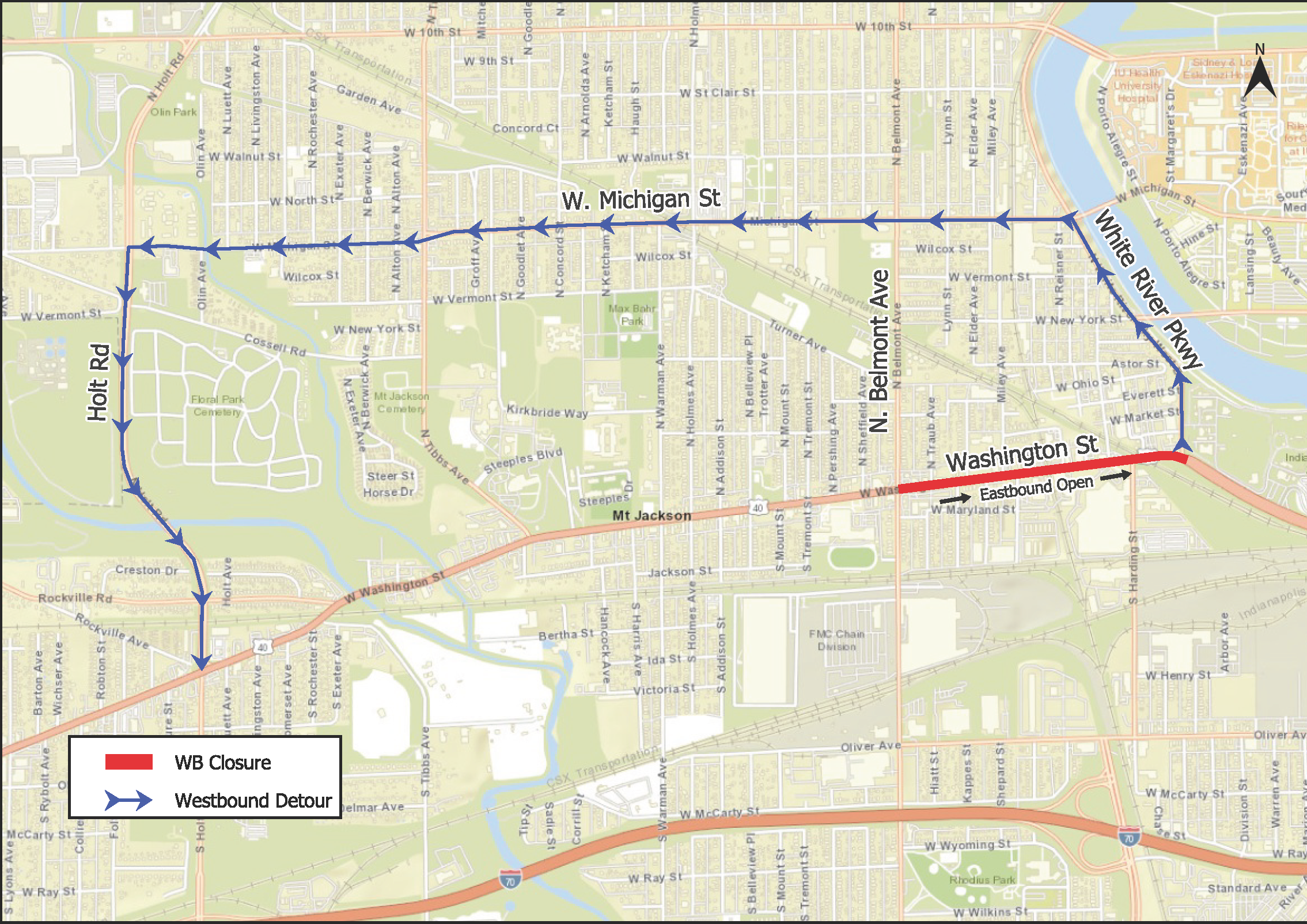

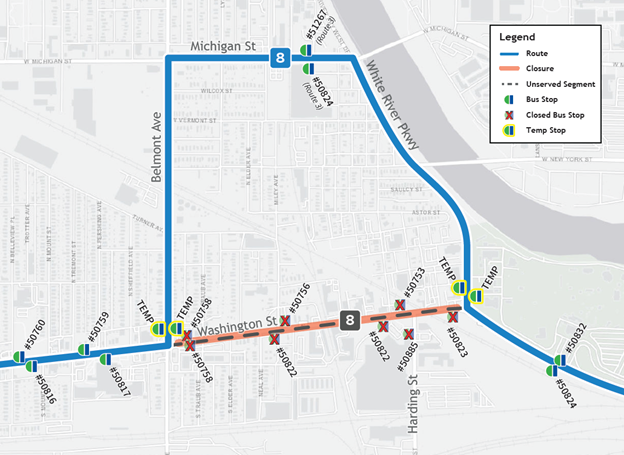

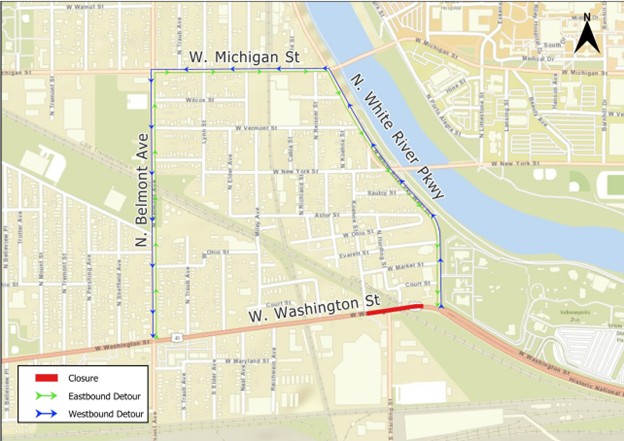

In September, Washington Street will be closed from Rockville Road to Belmont Avenue. Buses will detour around the closure using Belmont Avenue, Michigan Street and Holt Road. Stops 50758, 50759, 50760, 50762, 50763, 50764, 50766, 50768 and 50769 will be closed.

Southeastern Avenue to State Avenue
Motorist Detour

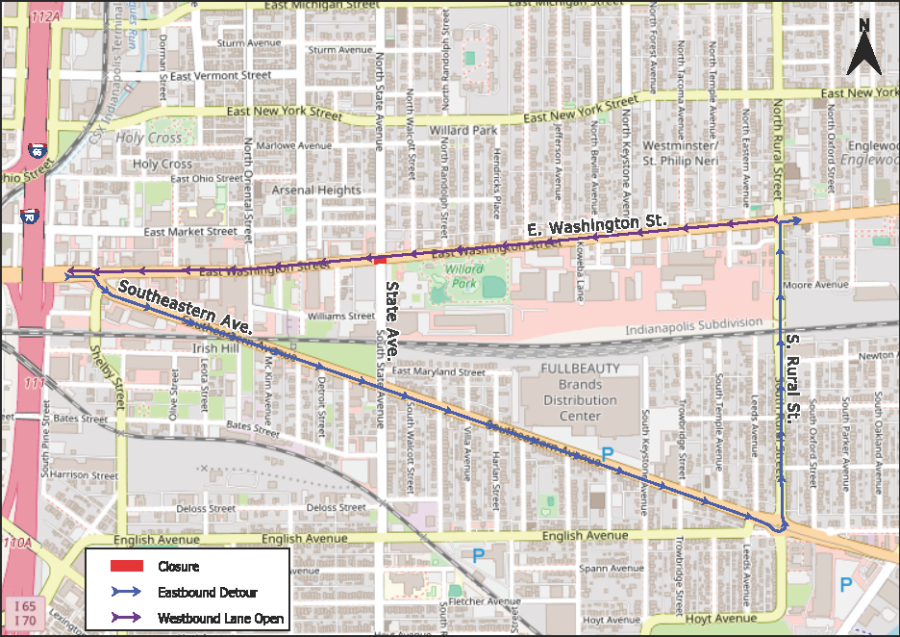

From Southeastern to State avenues, Washington Street is closed to eastbound traffic for storm sewer construction and sidewalk and pavement restoration. Eastbound traffic is being detoured onto Southeastern Avenue and north onto State Avenue to return to Washington Street. Westbound access will be maintained in a single lane during construction.

Rider Detour

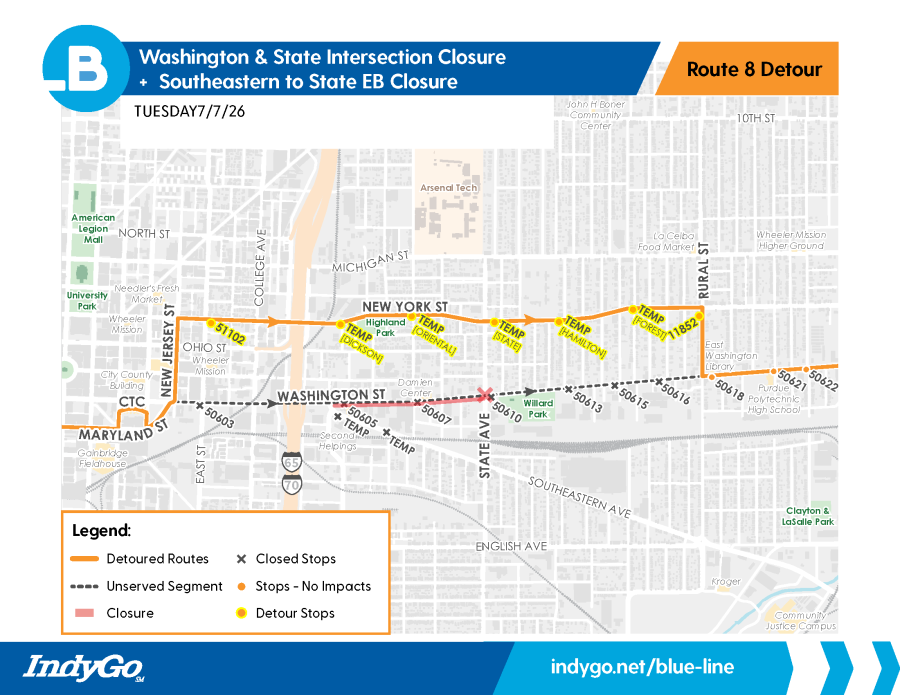

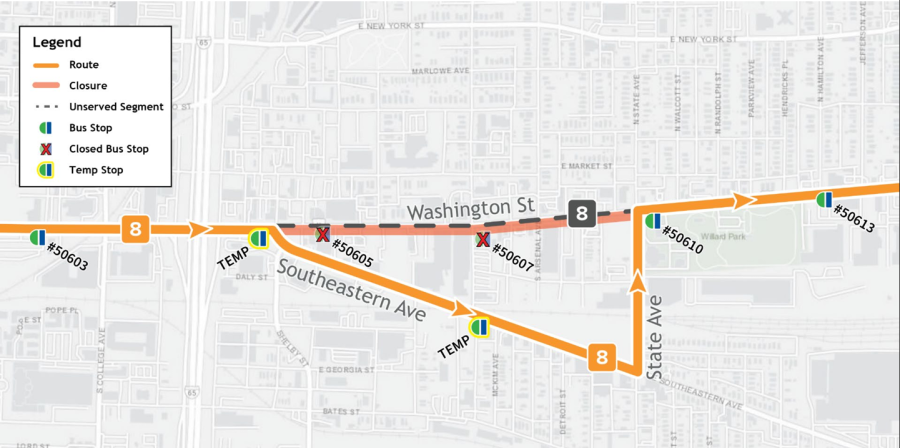

Washington Street is closed from Southeastern to State avenues. IndyGo’s Route 8 is on an eastbound detour using Southeastern and State avenues. Bus stops 50605 and 50607 are closed. Temporary stops are available along Southeastern Avenue, State Avenue and New York Street.

Emerson Avenue to Ritter Avenue
Motorist Detour
The north side of the intersection of Washington Street and Emerson Avenue is closed for sanitary sewer construction. Due to unforeseen circumstances, this closure will extend beyond the originally anticipated 12-day period.

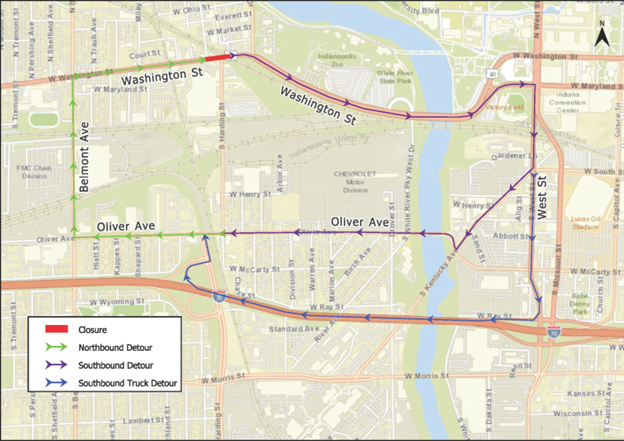

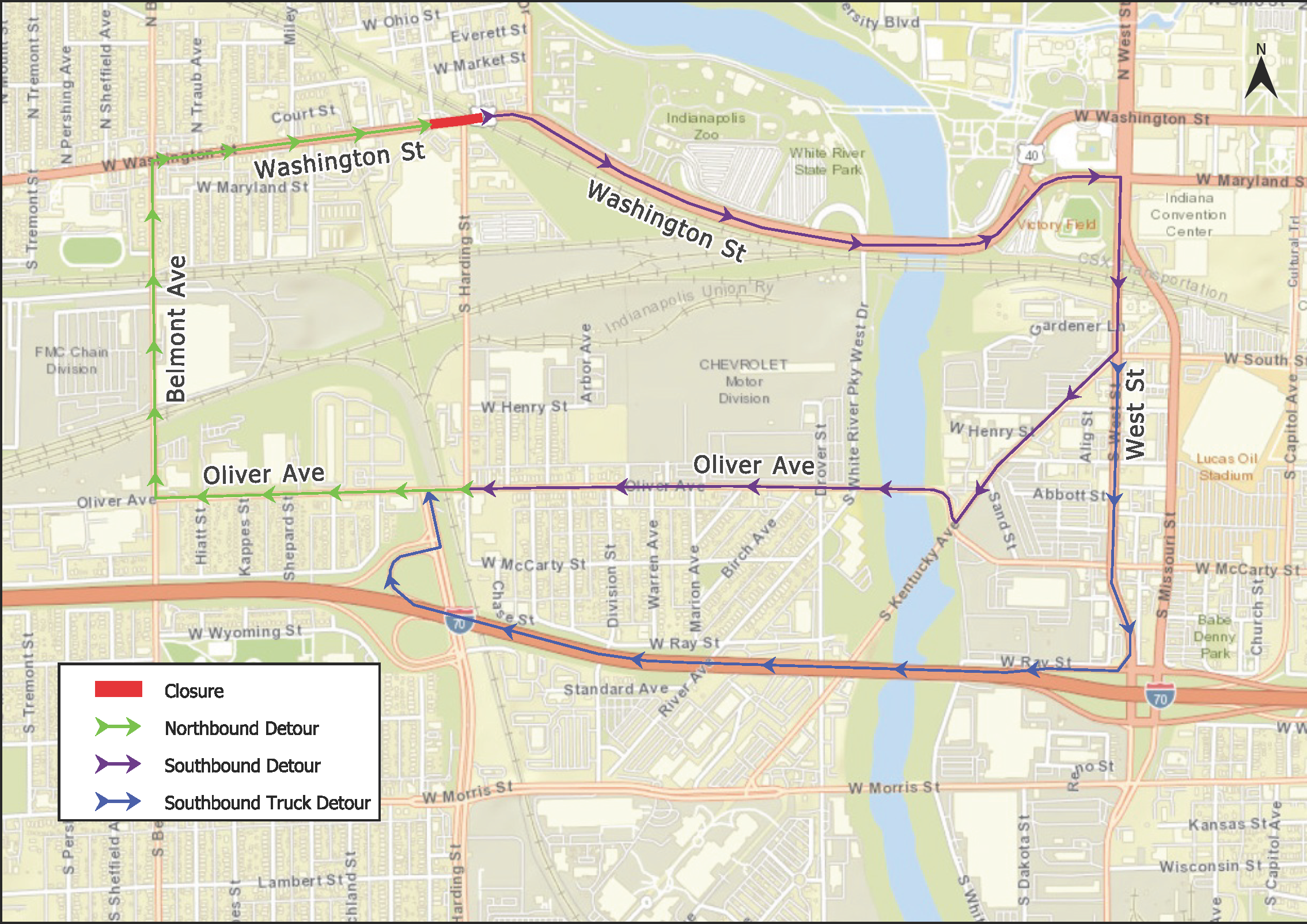

North and southbound traffic along Emerson Avenue will be detoured along 10th Street, Arlington Avenue, Brookville Road and English Avenue to access Emerson Avenue.
West and eastbound traffic along Washington Street will be detoured north onto Sherman Drive and east onto New York Street to access Emerson Avenue.

Rider Detour

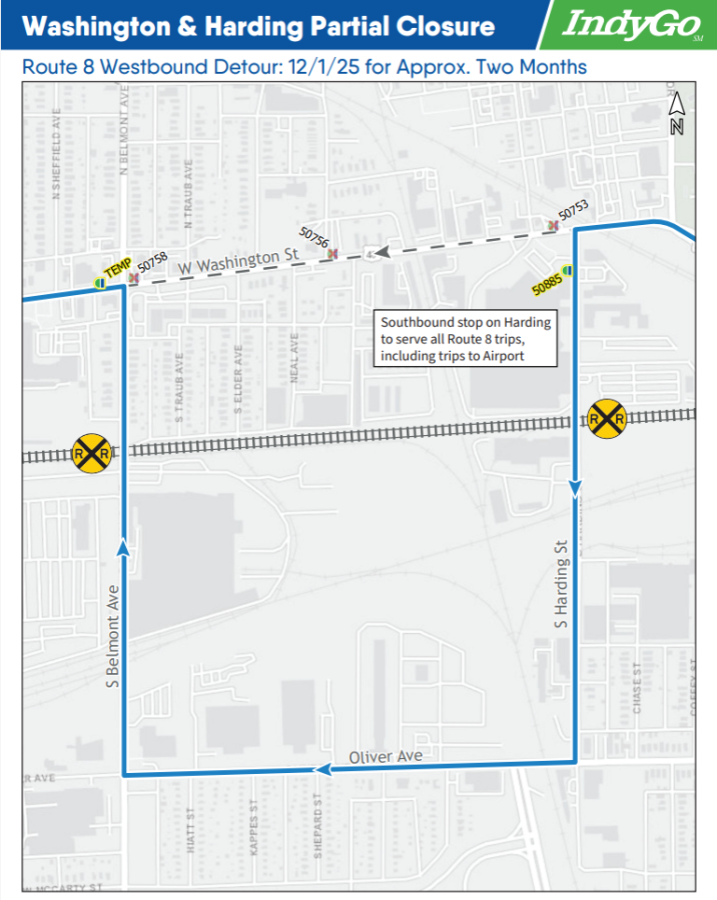

On or after Dec. 1, Washington Street will close to eastbound traffic between Emerson and Arlington avenues. The detour will use Emerson Avenue, Pleasant Run Parkway South Drive, Michigan Street, Pleasant Run Parkway North Drive and Arlington Avenue. Bus stops 50635, 50637, 50639, 50640 and 50641 will be closed.
A temporary stop on Emerson Avenue will be available.
